How Sprints Work in Microsoft Planner Premium

Posted on October 21, 2026
Planner

One key capability of Planner Premium (yes, the one that requires additional licenses) is managing Sprints for Agile and Scrum projects. In the past, we used Planner buckets to create Sprints, but now Sprints have a default field on the task card plus their own view. Let me show you how you can use it to your advantage.

How to access and utilize the Sprint capability in Planner Premium

Very important: this feature is only available in Planner Premium, not the regular Planner included in Microsoft 365 plans. In other words, you need the right licenses.

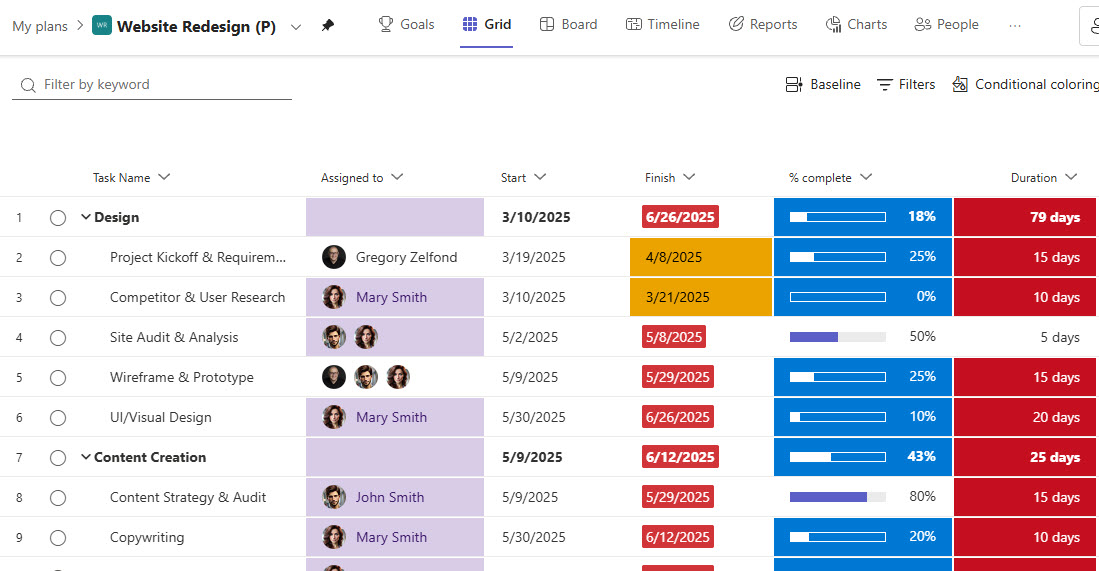

  1. To demonstrate the capability, I will be using one of the task plans I already havePlanner Premium Grid view of a Website Redesign plan with tasks and dates

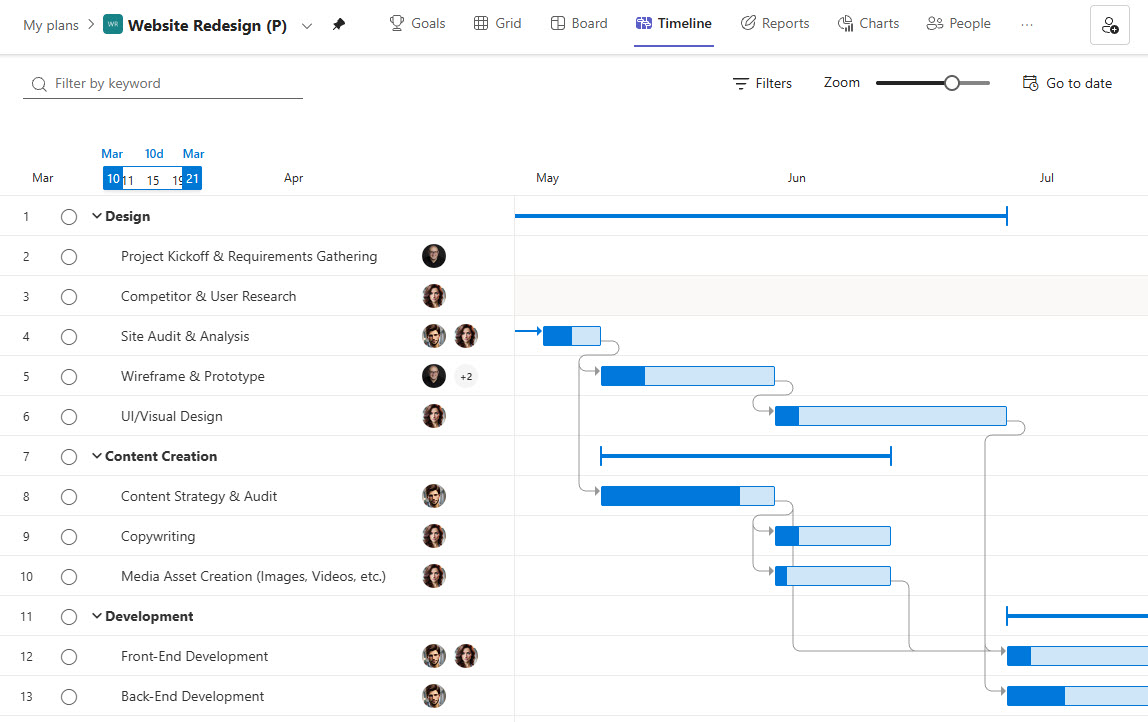

  2. Since this is Planner Premium, I also have the Gantt Chart (Timeline) view of the same plan with dependencies and task durations for all tasksHow Sprints Work in Microsoft Planner Premium

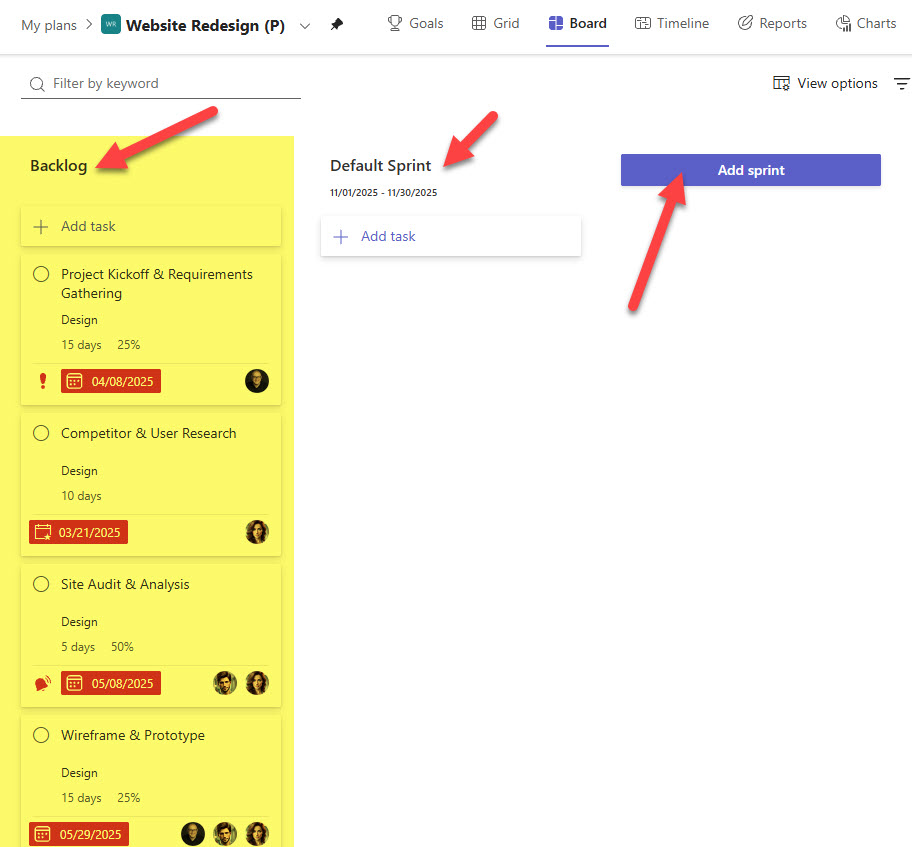

  3. To access “Sprint View”, click on Board, then Group by Bucket, then SprintHow Sprints Work in Microsoft Planner Premium
  4. By default, it will add all tasks on the plan to the Backlog “Bucket”. You can also create buckets for Sprints and set Sprint Start and end dates.How Sprints Work in Microsoft Planner Premium

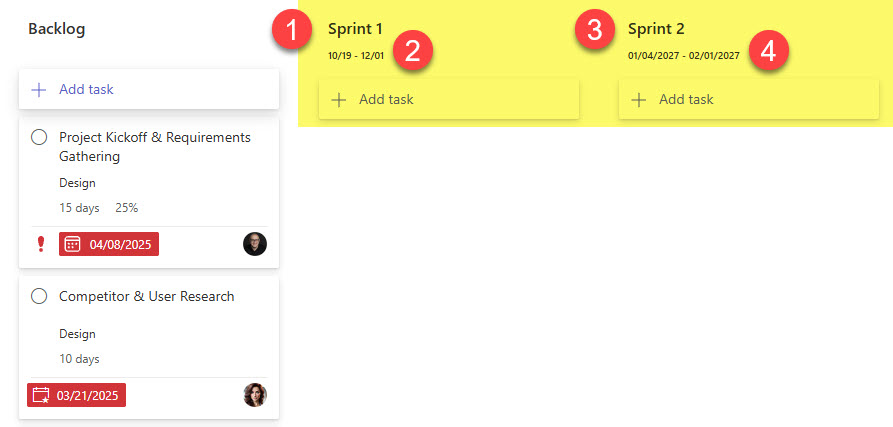

  5. Here is an example of me naming Sprints and setting dates on themHow Sprints Work in Microsoft Planner Premium
  6. Just like with a “regular” Board, you can drag and drop tasks from Backlog to Sprint Buckets.How Sprints Work in Microsoft Planner Premium

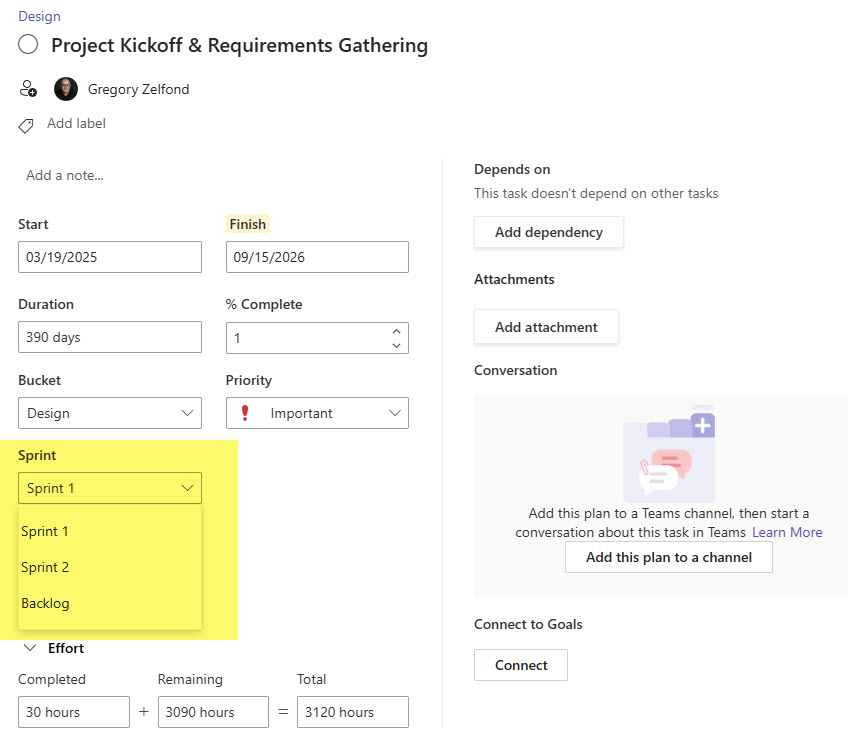

  7. Alternatively, you can change the Sprint association by opening up a task as well.How Sprints Work in Microsoft Planner Premium

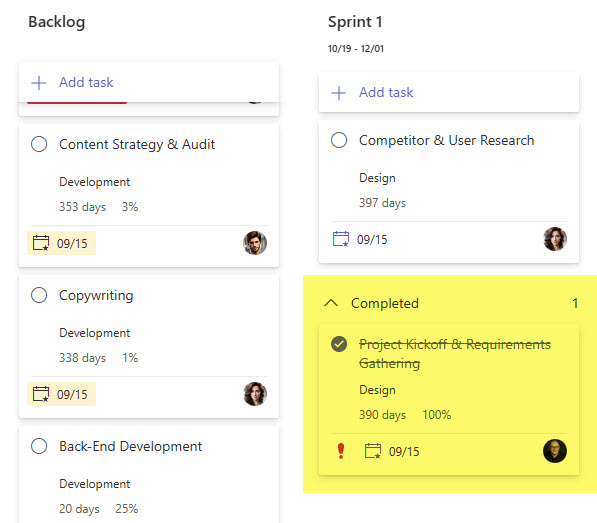

  8. Other than that, the Sprint View works the same way as the “regular” Plan Board view. A few examples below.Planner Premium Sprint view with Backlog and Sprint 1 buckets and a completed task

How Sprints Work in Microsoft Planner Premium



Nuances about Sprint capability in Planner Premium

  • Backlog is the default bucket. Any task not assigned to a sprint automatically goes to the Backlog bucket.
  • Sprint buckets do not drive scheduling. Assigning a task to a sprint does not set or constrain its start/due dates. In other words, the Timeline (Gantt chart) ignores sprint boundaries and instead follows task dependencies set within the task.
